Piha Domain Upgrade - June 8 Start
Your Piha Ratepayers and Residents Assn. has received the following uodate and schedule of work from Aucjkand Council, Parks & Community Facilitues.
Kia ora Piha Community Organisations,
We are happy to advise that the works on the driveway and amenity upgrades within Piha Domain will commence on Monday 8 June.

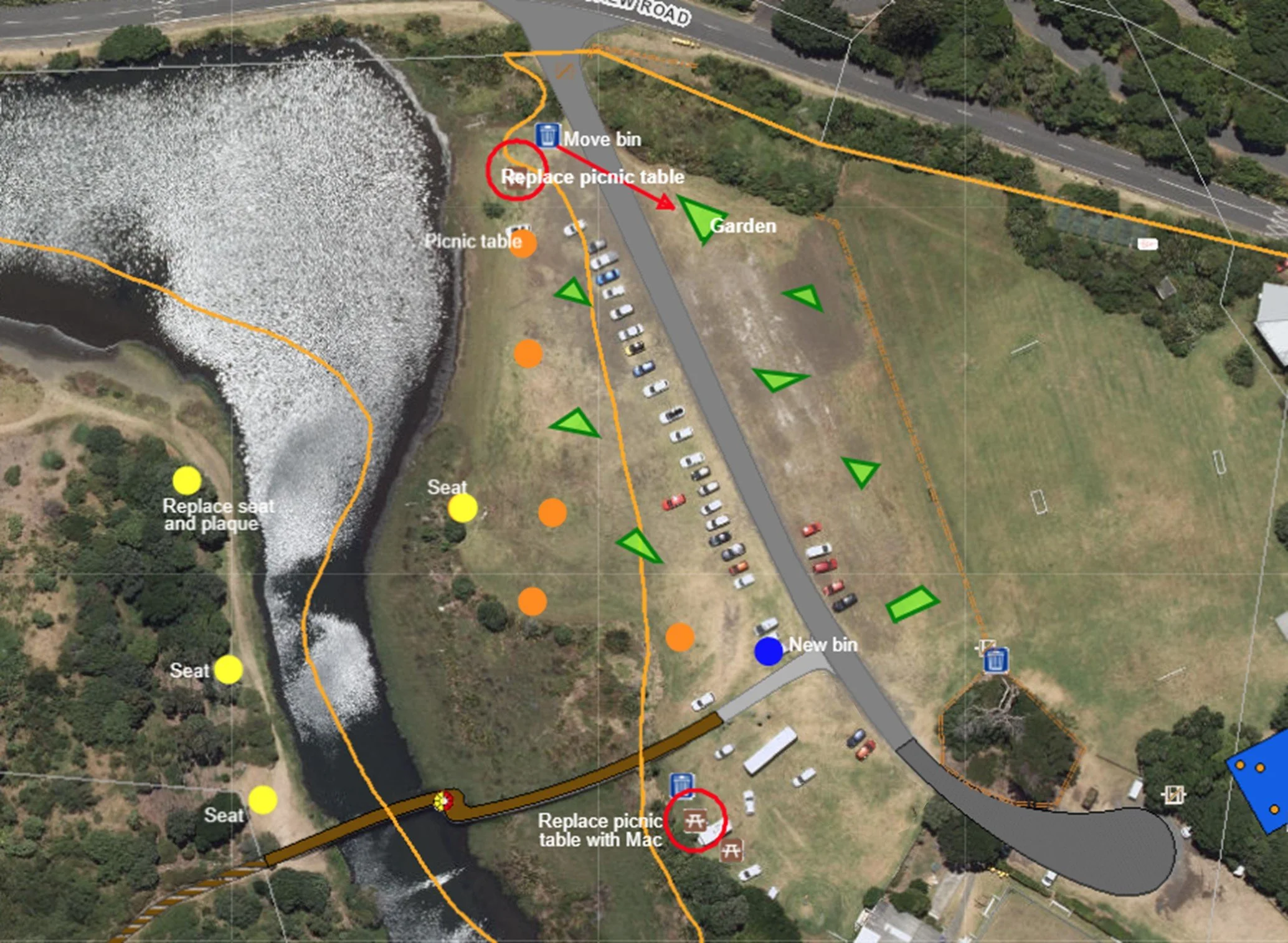

The attached plan reflects the final design developed through workshops with the Waitākere Ranges Local Board and Piha R&R Association. (See Plan HERE.)
Project Scope:
Installation of five new picnic tables, including replacement of two existing tables
Replacement of one existing seat and installation of three additional seats
Construction of eight garden beds to enhance amenity and help guide vehicle movement
Installation of one new bin
Resurfacing and edging of the driveway and playground carpark
Timing:
Start date: Monday 8 June
Duration: Approximately three weeks, subject to weather and site conditions
What to expect:
Temporary disruption to access and parking while works are underway
Traffic management in place where required
Minor refinements may occur during delivery, including adjustments to garden placement to respond to site conditions.
